Preview build. The flagship report and its exhibits are final; insights, other reports and their exhibits remain placeholders pending editorial review.

Flagship report · Edition 1

Check existing capacity before approving a new line

Why the next line should be found before it is funded, and how to price the one already standing.

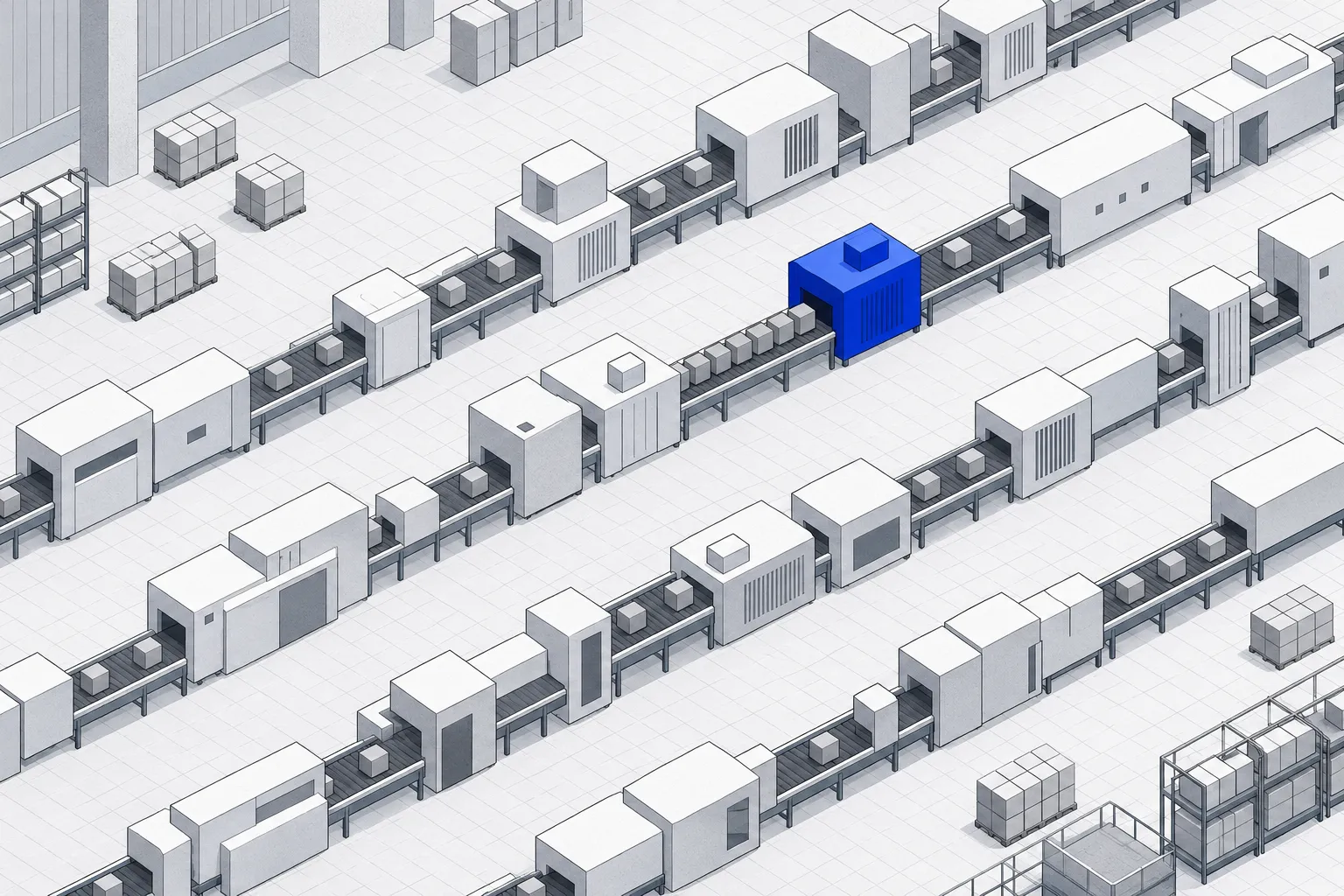

Isometric illustration of a production hall with four parallel lines; one machine station is blue, with a queue of units waiting before it: the constraint.

From the flagship report

Six published figures frame the case

  • 75.7%

    Capacity utilization, US manufacturing, August 2026 (preliminary); 1972–2025 average 78.2%

    CAP-001

  • 66 hours

    Average plant hours per week in operation, US manufacturing, Q2 2026, of 168 in a week

    CAP-006

  • 22.2%

    Plants below full capability citing insufficient labor, Q2 2026; 11.5% cite equipment limitations

    CAP-005

  • 0.5% a year

    Manufacturing productivity growth in the current business cycle; long-term rate 2.1%

    CAP-024

  • $314.3 billion

    Capital spending on structures and equipment, US manufacturing companies, 2022, nominal

    CAP-017

  • 78.5%

    Share of full production capability used by US manufacturing plants, Q2 2026 (±2.4); Census flags low response coverage

    CAP-004

Data as of October 9, 2026. CAP marks a published statistic; the full source for each is in the report's notes.

Exhibit 13 · Putting a price on lost hours

Three ways to buy an hour

On the report's illustrative line, recovery is cheapest for a few hundred hours, recovery plus weekend scheduling for up to about 2,200, and only a new line covers more (Illustrative).

Exhibit 13

In the illustrative case, the cheapest hour depends on how many the plant needs

Illustrative data

Annual cost per productive constraint hour actually needed, by option and by hours needed a year, illustrative line, dollars per hour

$0$1,000$2,000$3,000$4,00001,0002,0003,0004,0005,000Productive hours needed a yearRecover(up to 328 h)Schedule weekend hours (up to 1,875 h)Recover, then scheduleBuild a new lineBeyond 2,203 h, only a new line covers the need

Note: Recover: $300k a year program, up to 328 h (25% of losses). Schedule: weekend hours at $800 per scheduled hour, $1,024 per productive hour, up to 1,875 h. Build: $12M line, 10 years, 10% cost of capital, $1.2M a year to run; adds 4,688 h.

Source: Illustrative data. Trapped Capacity illustrative model; assumptions in Chapter 5 and formulas in the method notes.

Latest insights

All insights
Abstract stacked contour plates around a hidden mass on a dark ground, one plate in blue.

The thesis

Trapped Capacity prices the capacity plants already own.

Plants lose output to stops, changeovers, slow running, rework and waiting. Trapped Capacity measures those losses and translates them into the terms a finance committee uses: hours, units, cash and payback.

Research reports

All research
  • Flagship report The capacity you already own October 2026

    Flagship report · Edition 1

    The capacity you already own

    Why the next line should be found before it is funded, and how to price the one already standing.

    Report · PDF

  • Research report Pricing a changeover Expected: to be confirmed

    Research report · Changeovers

    Pricing a changeover

    A working method for turning changeover minutes into a figure a finance committee can test.

    Forthcoming · PDF

  • Research report The slow-running ledger Expected: to be confirmed

    Research report · Measurement

    The slow-running ledger

    Why speed losses stay invisible in most reporting, and how to bring them into the monthly numbers.

    Forthcoming · PDF

Abstract grey rails converging through a narrow gate between two black blocks and fanning out, one rail in blue.

Method

Each loss is priced in three steps

Every loss is priced in three steps, with the assumption beside each one, so a finance partner can replace any input with their own.

Read the method

Abstract row of thin grey plates standing like editions in a series, with the next plate set apart in blue.

Subscribe

Before the next capital request, read the priced version

One email per finished piece: the number, the assumption behind it and the link to the method. Stop with one click.
